Ardrossan Project Update (May 2026)

News |

Ardrossan Project Update (May 2026)

Progress in the period includes:

  • Completion of operations under the Safe System of Works.
  • Completion of foul drainage installation.
  • Completion surface water drainage installation.

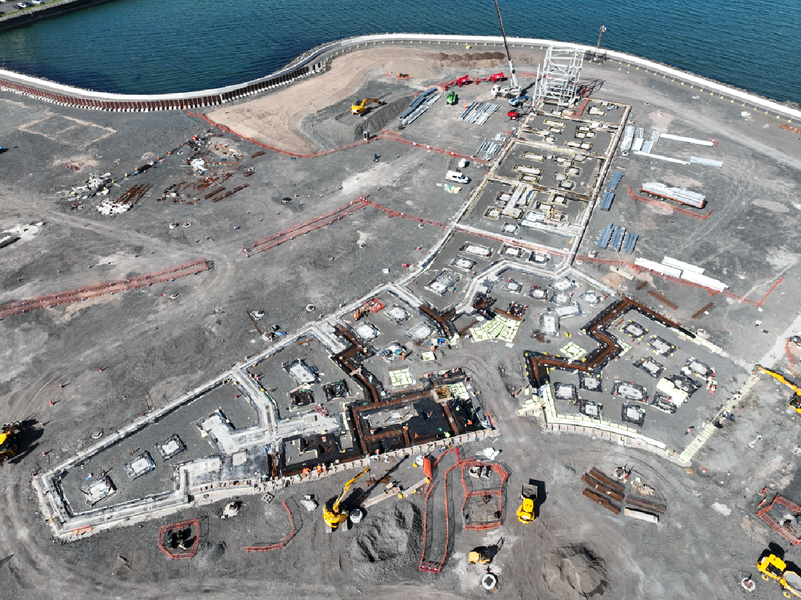

  • Continued foundations in Central Wing.
  • Commenced foundations in the gym hall.
  • Commenced pool plantroom & balance tank foundations and walls.

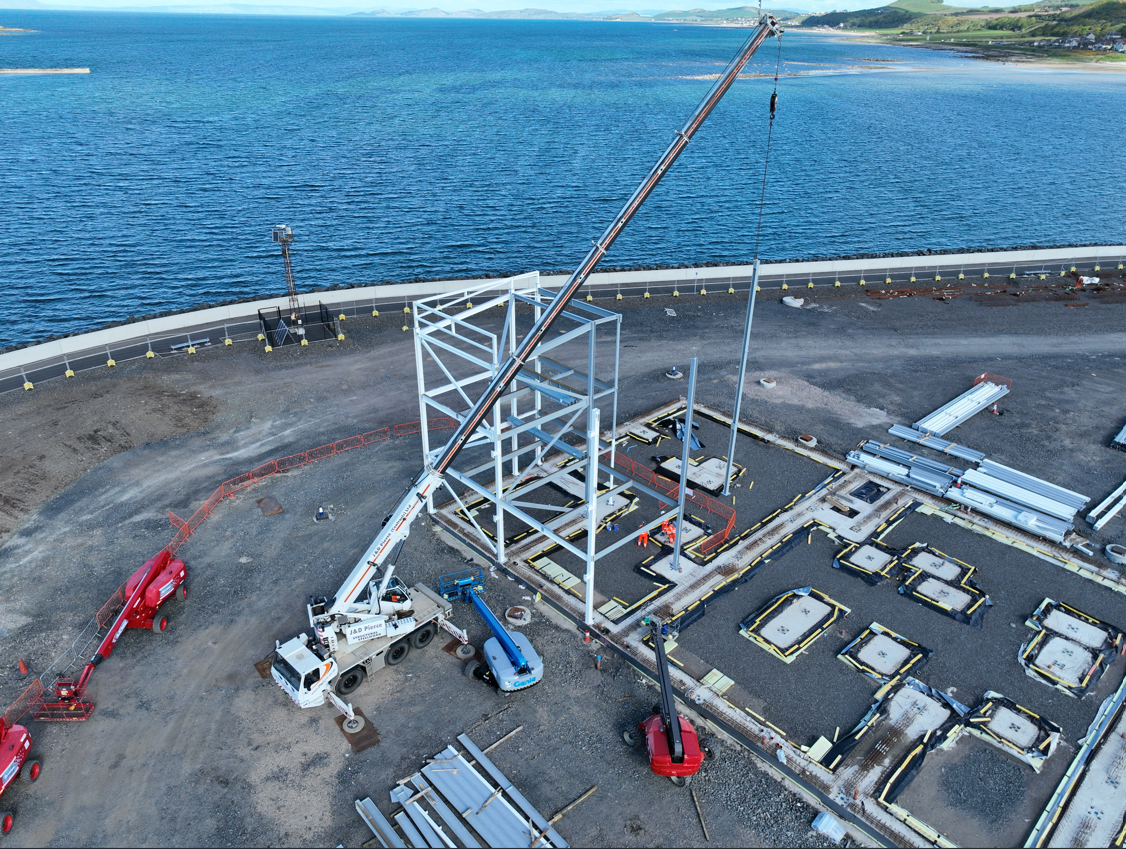

  • Commenced steel erection to Teaching Wing.
  • Commenced formation of soft landscaping mounds.

Works to be undertaken in next four weeks include:

  • Completed foundations in Central Wing.
  • Continue steel frame erection in Teaching Wing.
  • Continue foundations in Sports Wing.
  • Continue pool balance tanks & plantroom walls.
  • Commence scaffolding access and handrails.
  • Commence concrete stairs installation.
  • Commence metal decking to Teaching Wing.
